Moonee Valley Racecourse Redevelopment

Project completion Ongoing
Location Moonee Ponds, VIC
Client Moonee Valley Racing Club
Sectors Sports and recreation, Community infrastructure

Building The Valley Of Tomorrow.

The redevelopment of Moonee Valley Racecourse is transforming one of Australia’s most iconic racing venues into a new destination for racing, entertainment and the wider community. As part of the redevelopment, Symal is delivering the civil and infrastructure works supporting a new racetrack and associated facilities, including major earthworks, drainage, underpasses, retaining walls, roads, car parks, shared user paths and new track lighting.

Delivered in a busy inner-city environment, the project requires careful staging and coordination across a complex network of contractors, stakeholders and surrounding residents. With racing set to return for the 2027/28 season, works are being progressively completed and handed over to turf specialists and other project partners to keep the broader redevelopment moving towards the Club’s vision for The Valley of Tomorrow.

4

new underpasses

201k

m³ earthworks cut

6.8km

drainage installed

51ML

dam capacity
Building. Better. Together.

Symal is delivering the civil and infrastructure works for Moonee Valley Racing Club’s once-in-a-generation redevelopment, helping transform the historic racecourse into a modern precinct built for its next chapter. The project follows a successful Early Contractor Involvement process, in which Symal’s technical and design management teams worked closely with the Club before construction began.

The scale of the civil works is significant. More than 200,000 cubic metres of material is being cut across the site, alongside 127,000 cubic metres of fill, 6.8 kilometres of drainage, 3.7 kilometres of hydraulic services and more than 27 kilometres of electrical conduits. Four underpass structures are also being delivered to provide access for horses, pedestrians and vehicles, supported by retaining walls, wingwalls, pump stations, dams, internal roads, car parks and shared user paths.

Progressive handovers have been central to keeping the wider redevelopment on track. All separable portions of the new track have now been handed over to turf specialist Evergreen Turf, allowing preparation of the racing surface ahead of the return of racing. The Maintenance Facility and Horse Stalls areas have also been completed and handed over to support the next stage of the broader redevelopment. To date, the project has recorded more than 123,000 labour hours with zero reportable injuries.

Beyond the racing track, the redevelopment is creating the infrastructure for a precinct designed to welcome the community well beyond race days. New roads, car parks, walking paths, lighting, drainage and services will support a transformed destination that brings racing, recreation, entertainment and community spaces together at The Valley.

  • 2025 • November

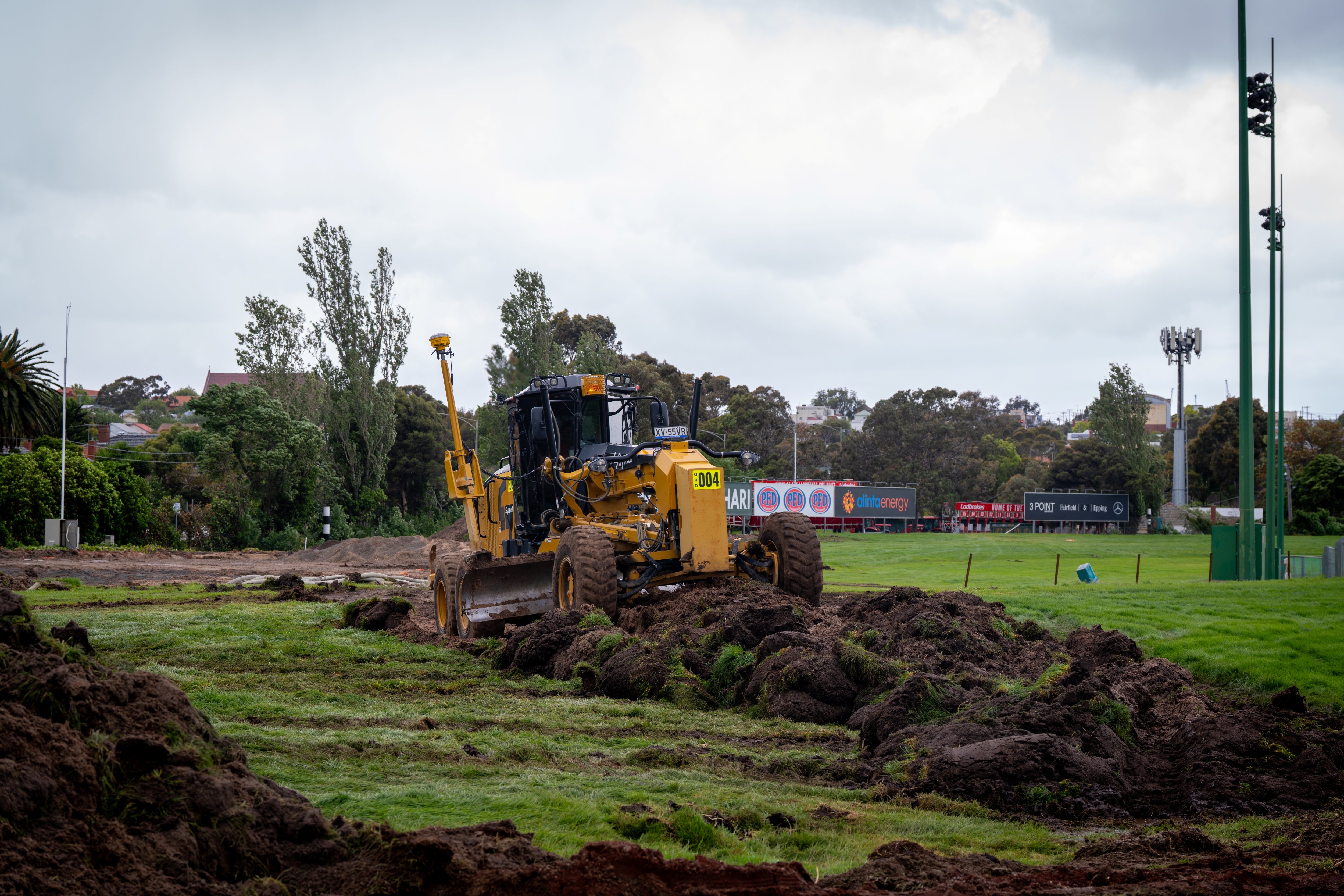

    Site establishment and early works

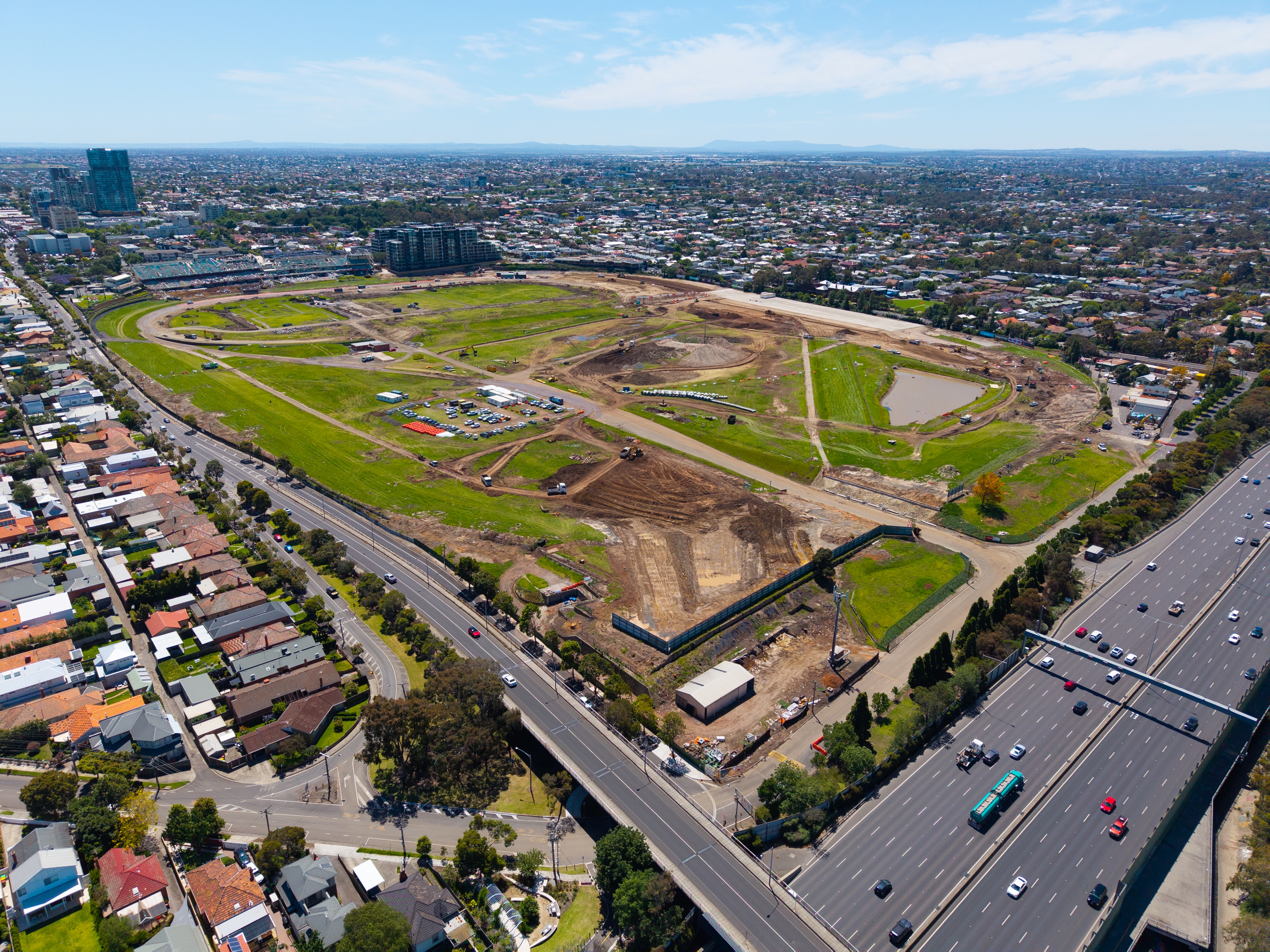

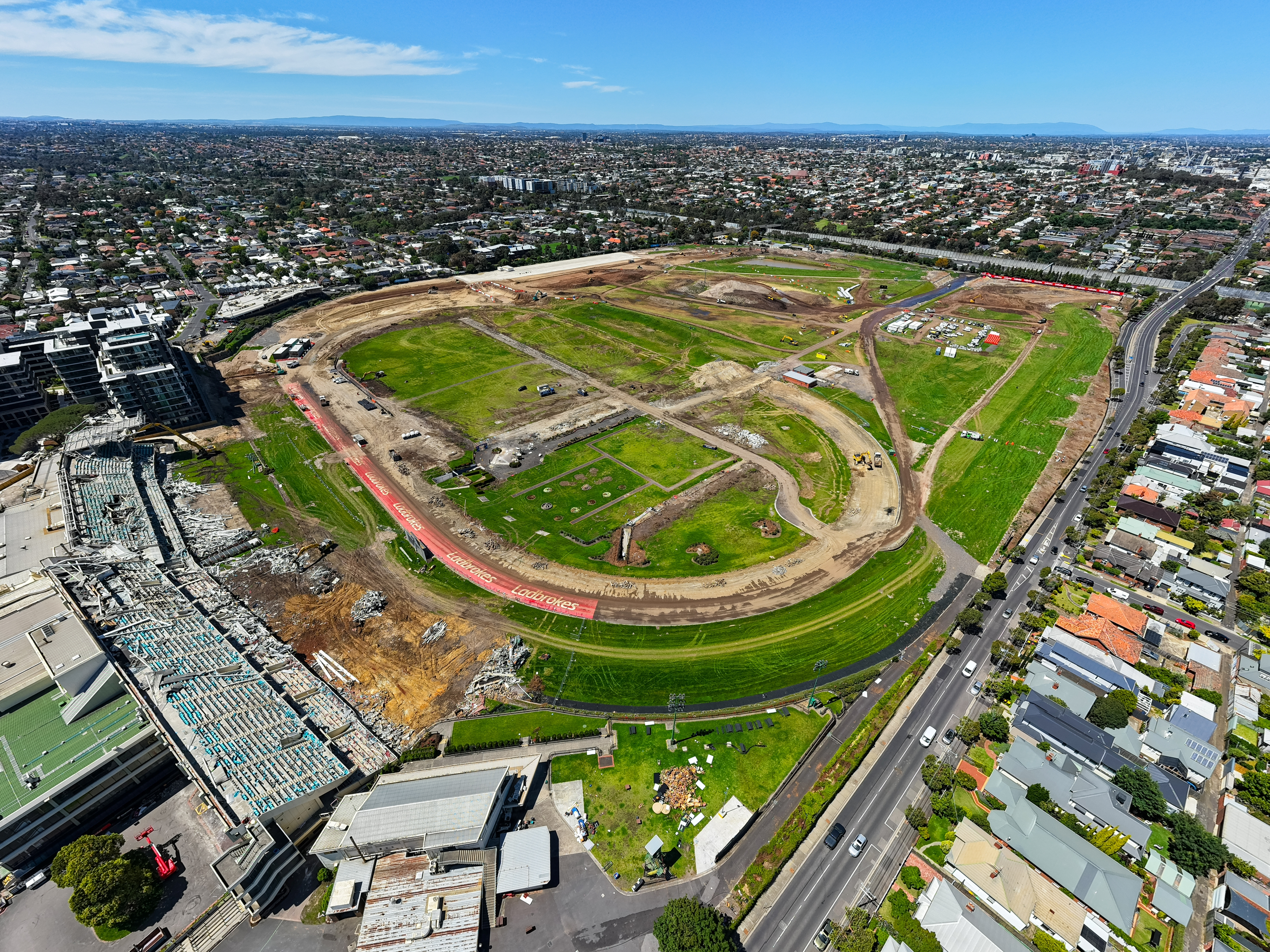

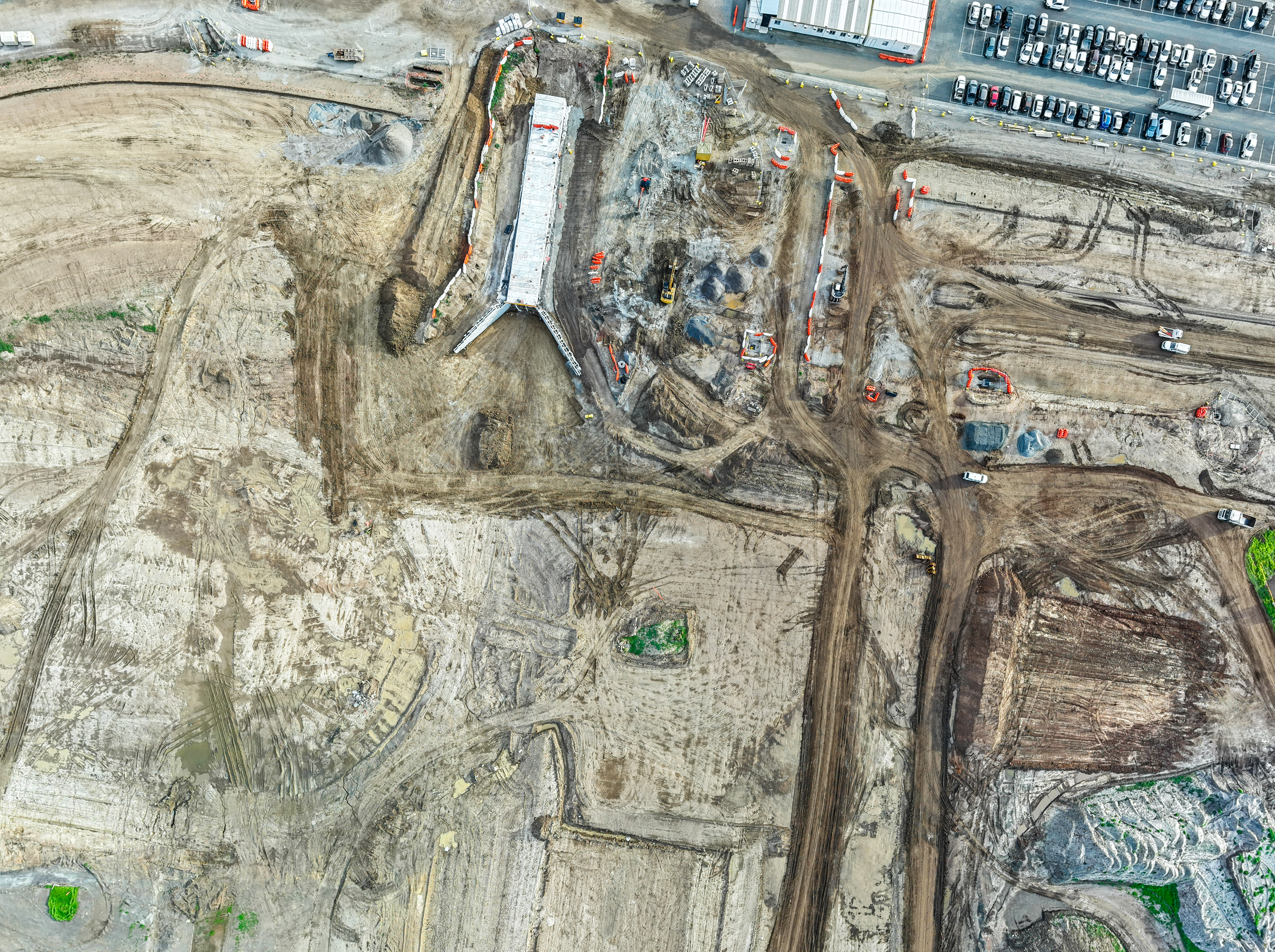

    The team hit the ground running, establishing the site and commencing demolition of above-ground structures and redundant underground services. Excavation also began for the Grandstand Underpass, marking the start of major civil works across the racecourse.
  • 2025 • December

    Bulk earthworks and underpass construction

    Major earthworks got underway across the racecourse, alongside construction of the Grandstand and Dean Street Underpasses. Drainage and pavement works also commenced in the northern precinct, while the main site compound and initial sections of the new drainage network took shape.
  • 2026 • January

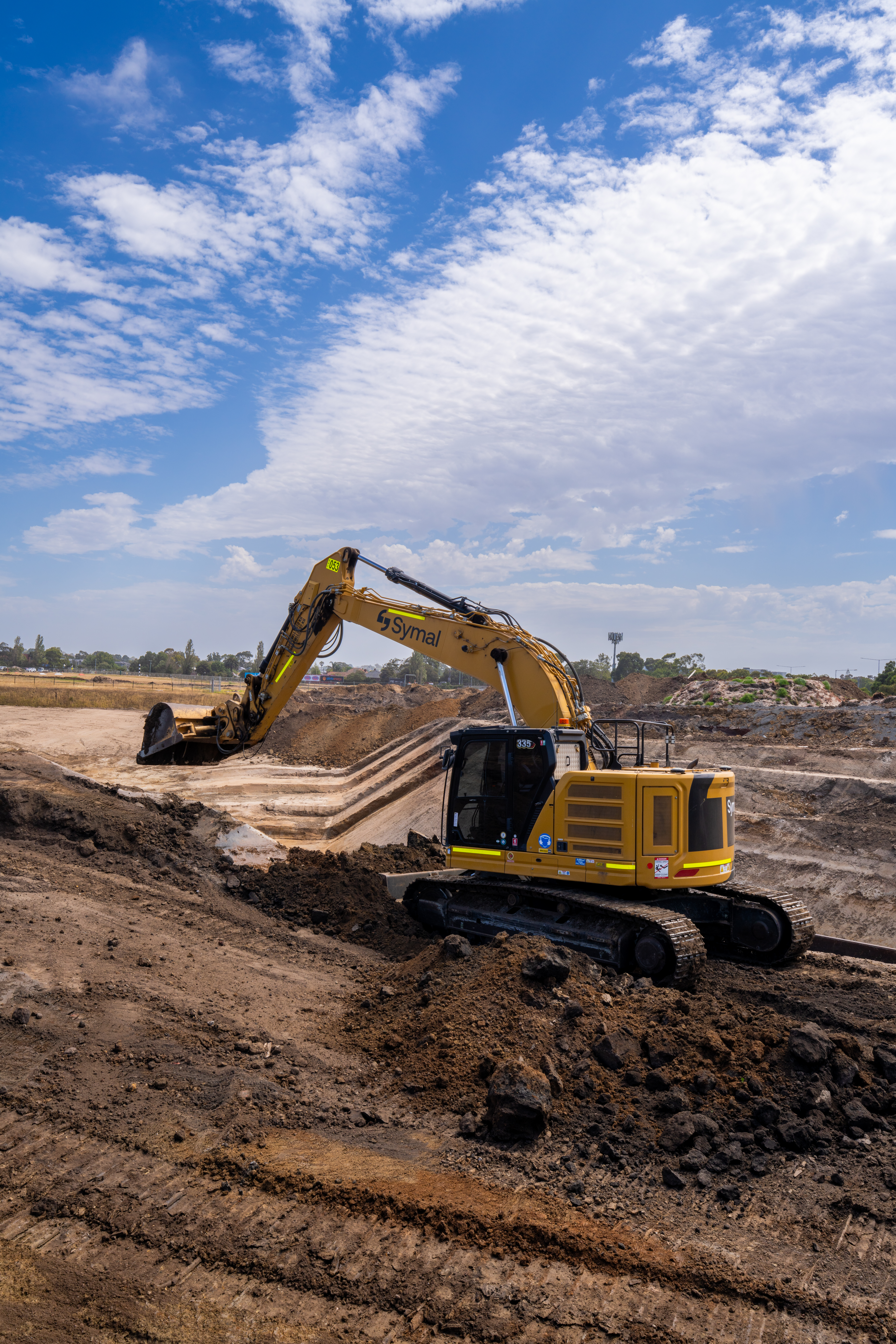

    Major earthworks and drainage

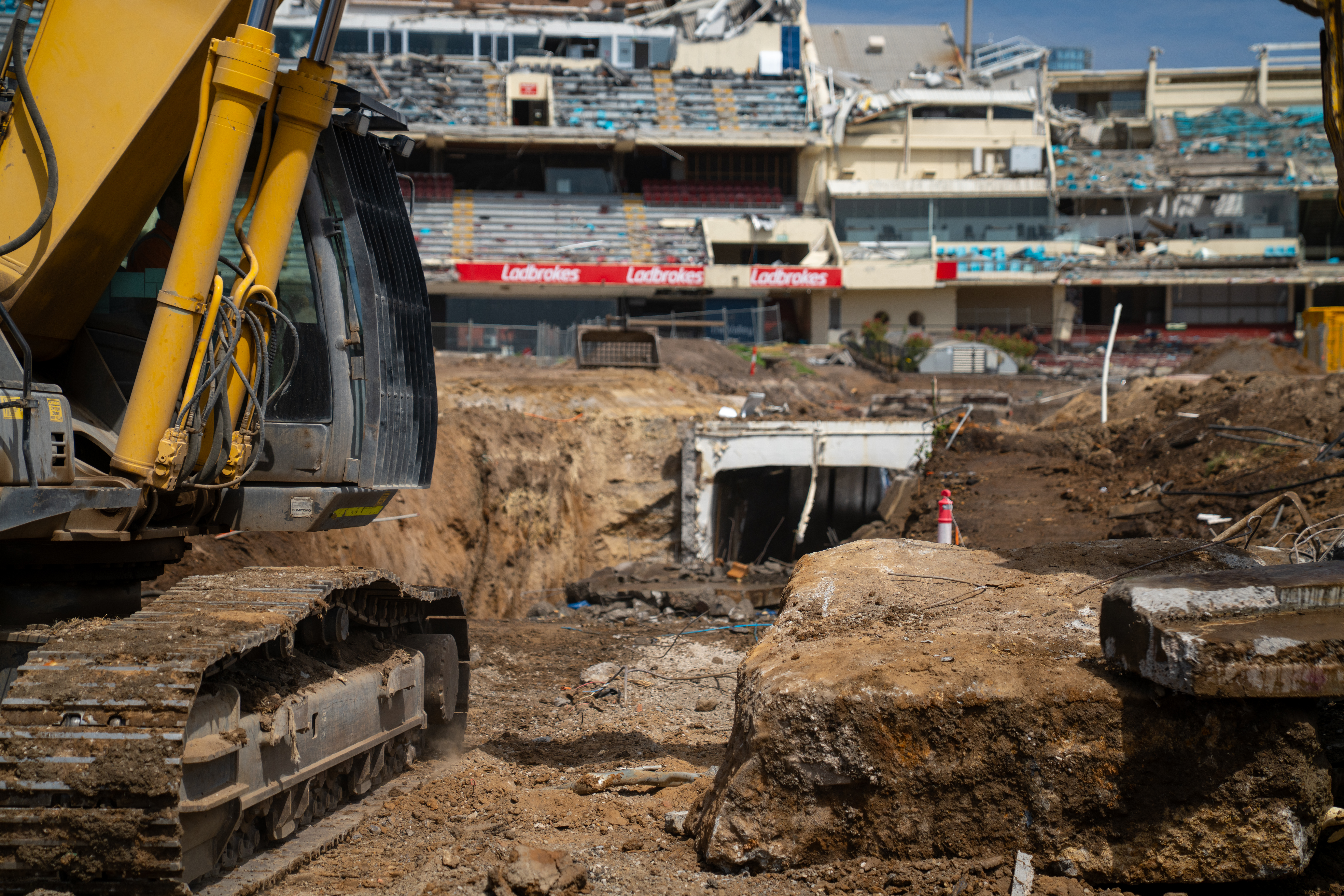

    Earthworks continued across the infield and underpass areas, with construction progressing on the Grandstand Underpass and the main drainage network. Demolition of redundant services also continued as the team prepared more areas of the site for construction.
  • 2026 • February

    Underpasses and electrical works begin

    Construction progressed on the Grandstand and Dean Street Underpasses, including their base structures and wingwalls. Major earthworks continued across the site, while excavation began for the Horse Underpass pump station and civil works for the new electrical infrastructure got underway.
  • 2026 • March

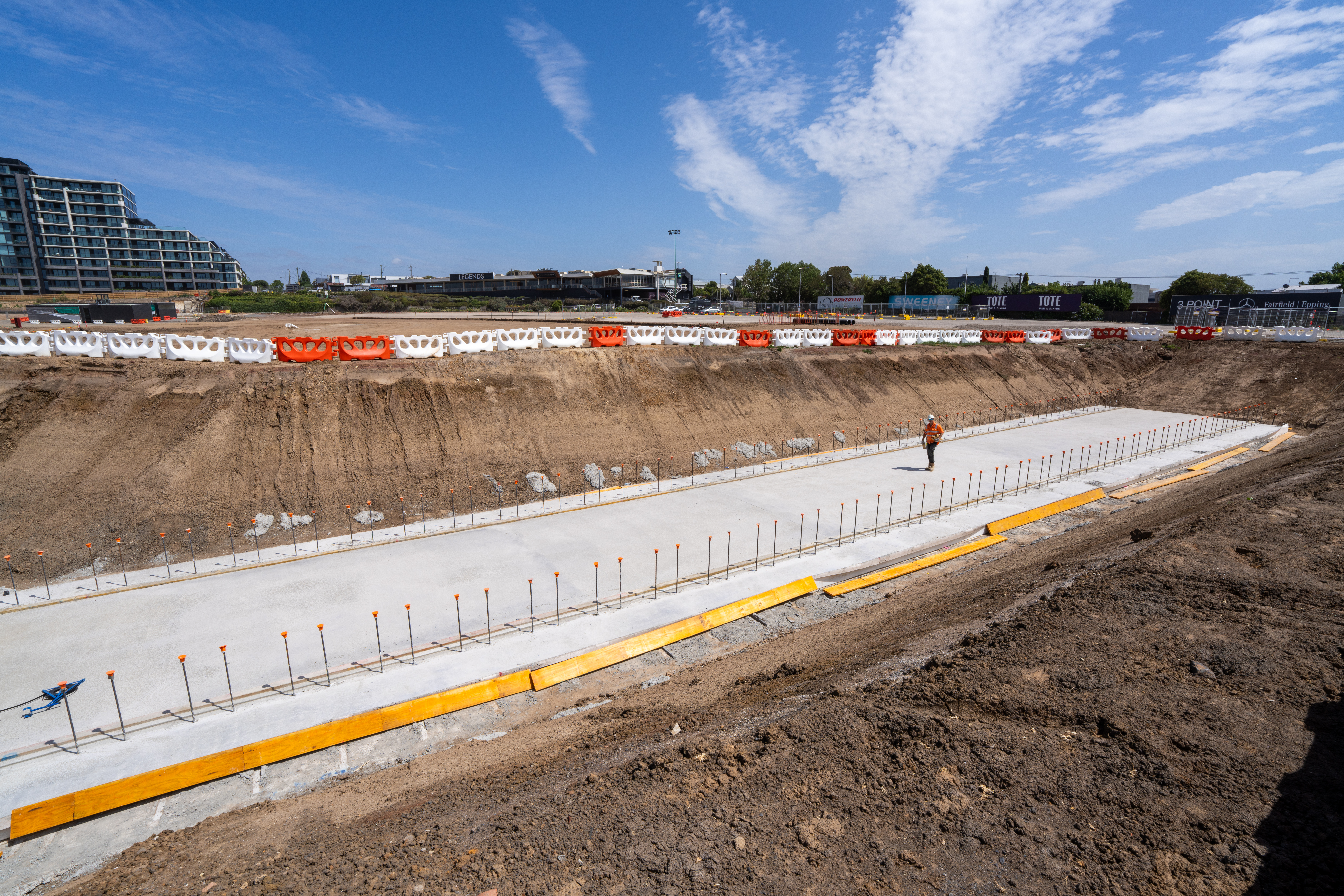

    Structures, drainage and track lighting

    Works progressed across the underpasses, with Dean Street Underpass taking shape alongside continued earthworks and drainage installation. The Horse Pump Station and a key component of the main drainage system were installed, while foundations for the new track lighting were established.
  • 2026 • April

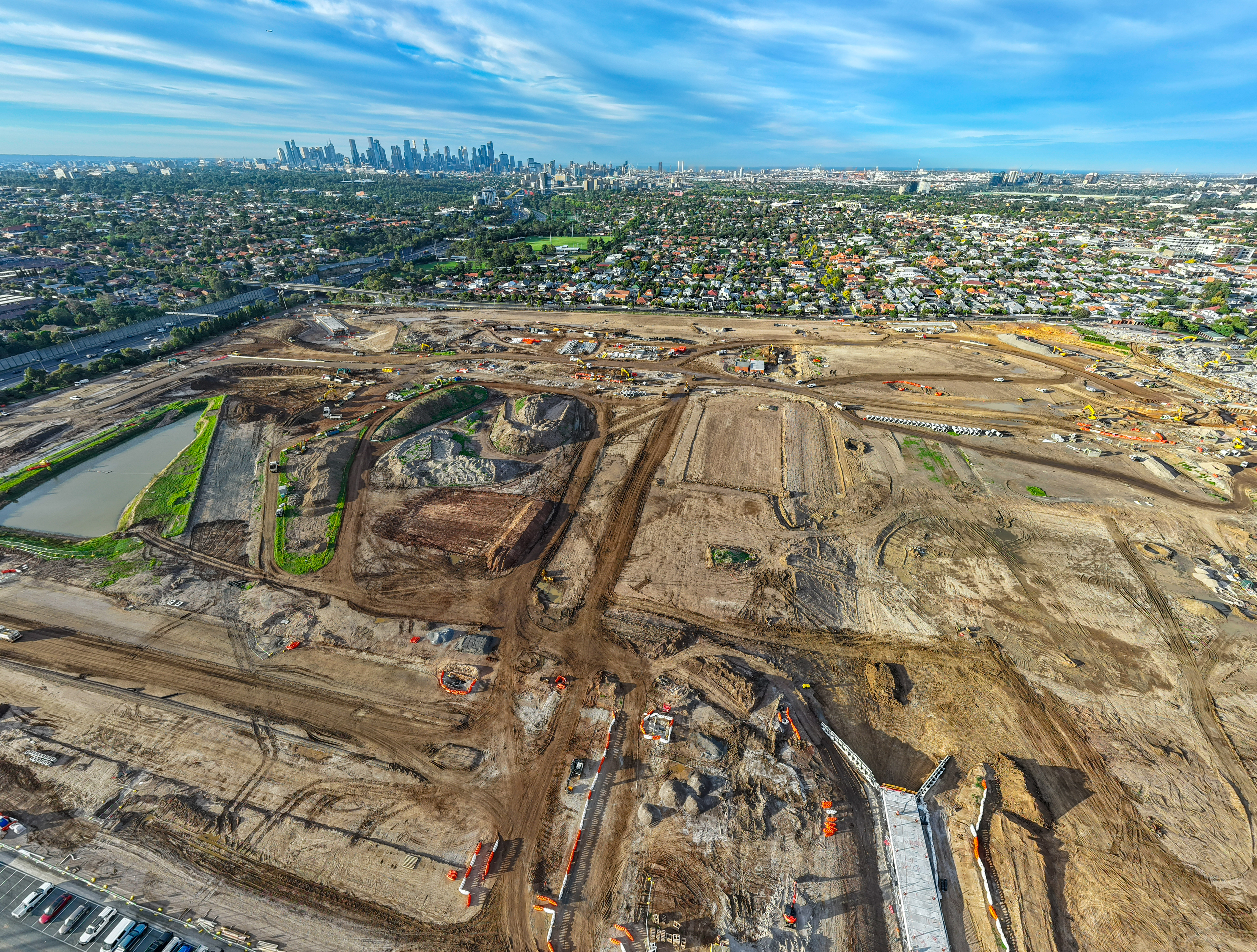

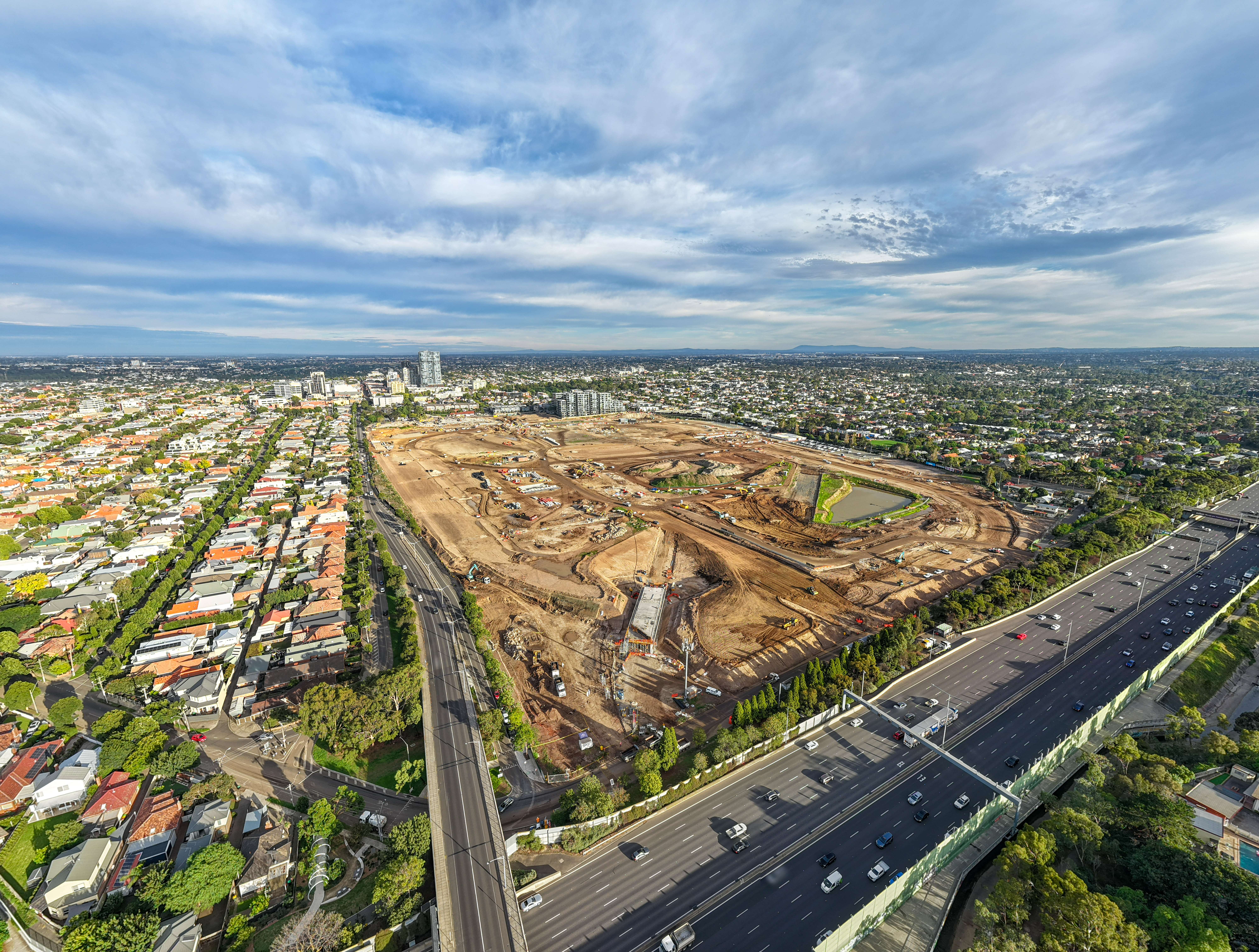

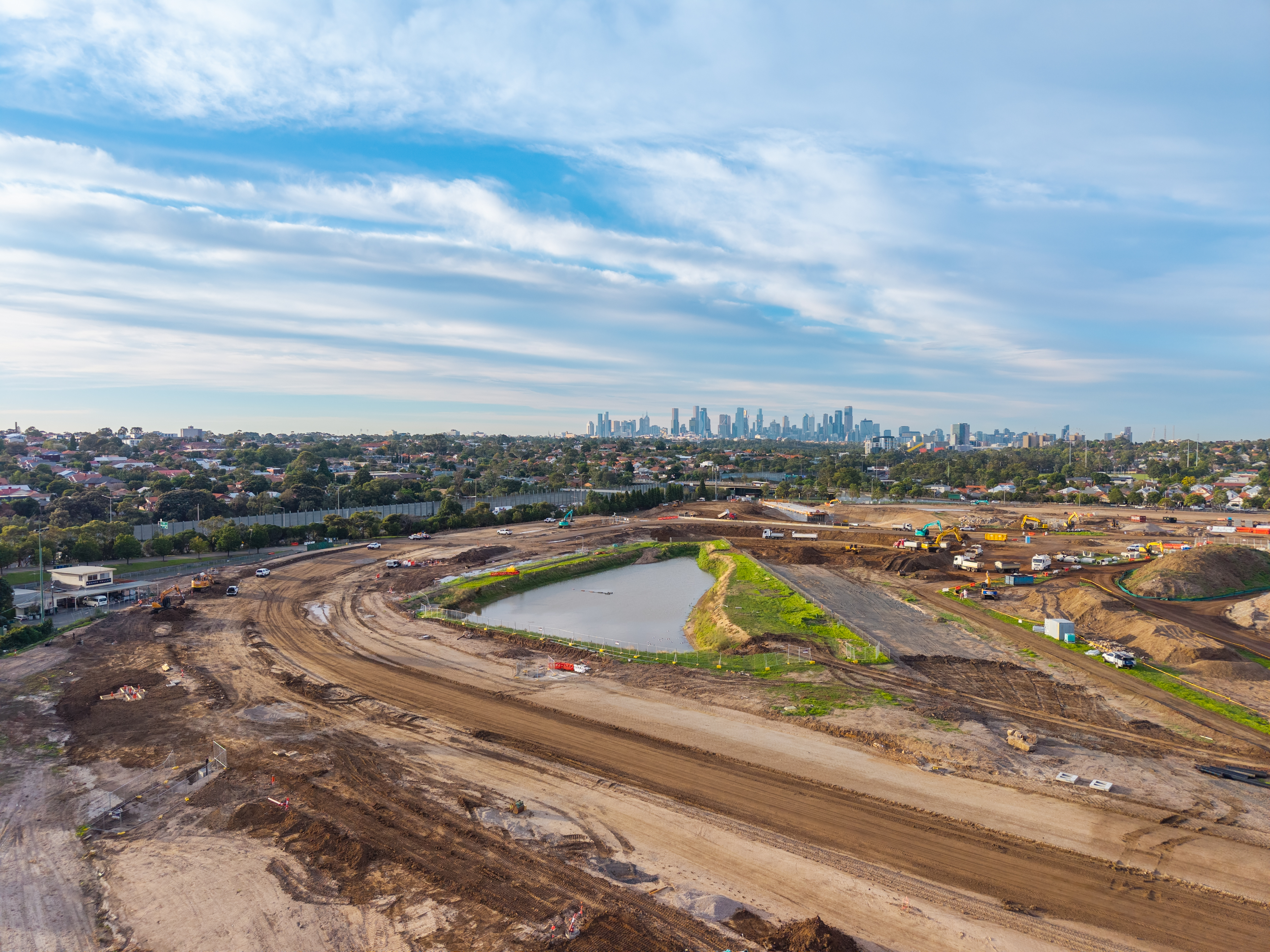

    Retaining walls and first track handover

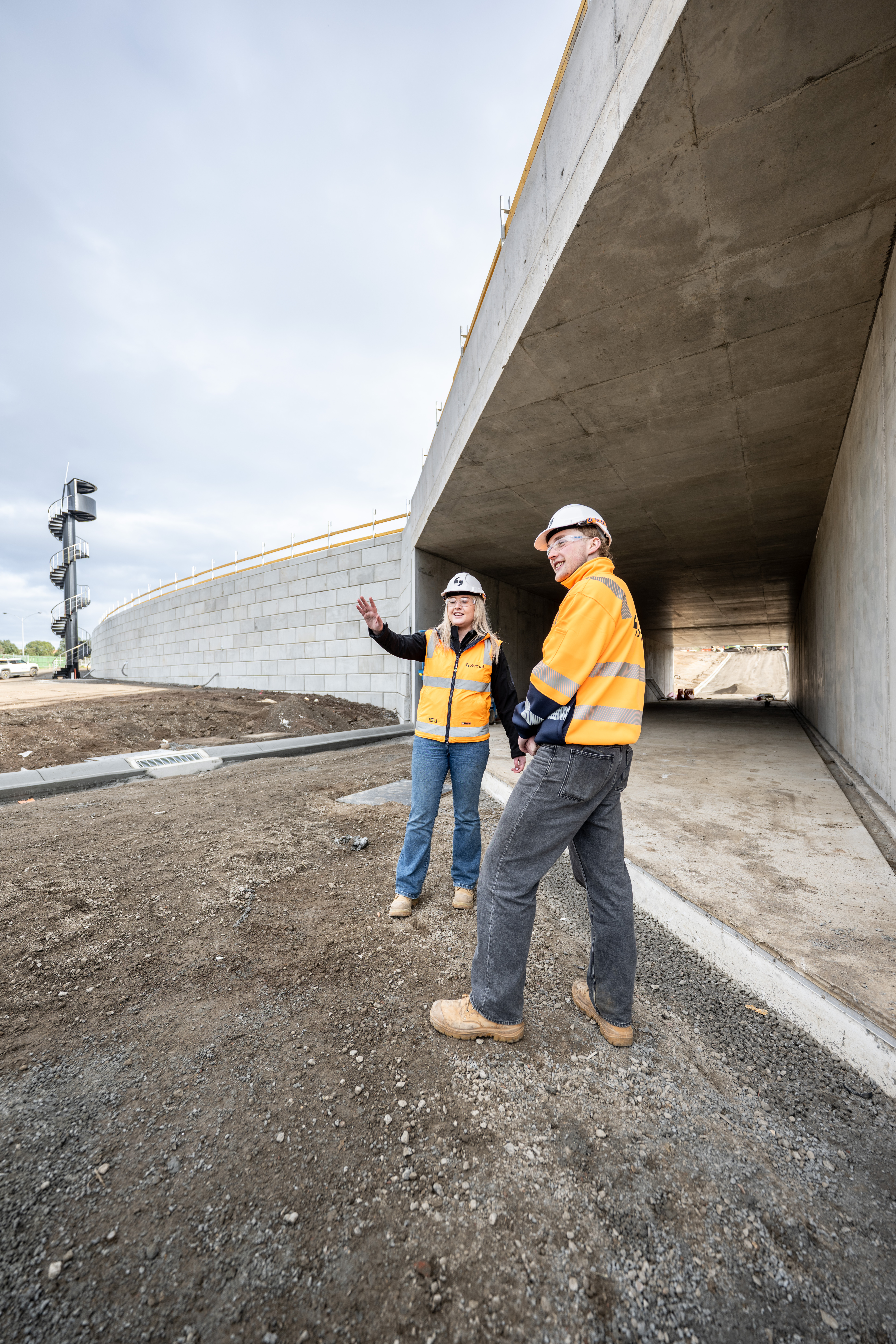

    Excavation began for one of the site's major new dams, alongside the installation of retaining walls and two new steward towers. The first section of the new racetrack was also handed over to the turf specialist, allowing preparation of the racing surface to begin.
  • 2026 • May

    Dams, drainage and structural works

    Major civil works continued across the racecourse, including construction of the new dams, extensive drainage installation and progress on retaining walls and underpass structures. Track lighting and steward tower works also continued, alongside underground service works.
  • 2026 • June

    Structural works and key handovers

    Track lighting poles were installed, with further sections of the new racetrack handed over to the turf specialist for turf preparation. Construction of the Horse Underpass progressed, while the Maintenance Precinct was handed over to allow the next stage of works to begin.
  • 2026 • July

    Horse Stalls handover and infield access

    Key retaining walls and wingwalls were completed, while construction continued on the Horse Underpass, Cox Place Underpass and new dam infrastructure. Drainage for the infield access road was completed, with the Horse Stalls precinct handed over and another section of track released to the turf specialist.

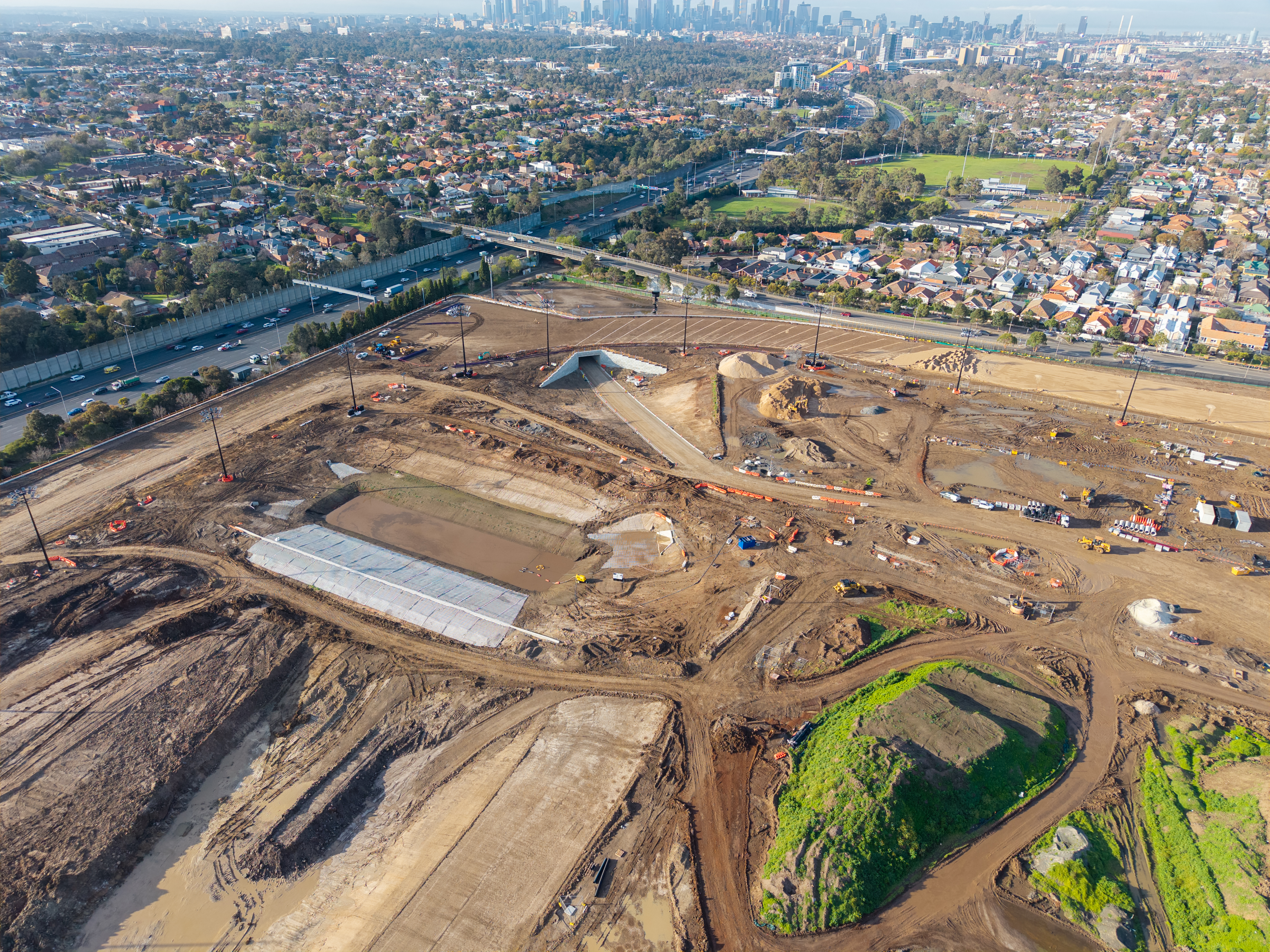

  • 2026 • August

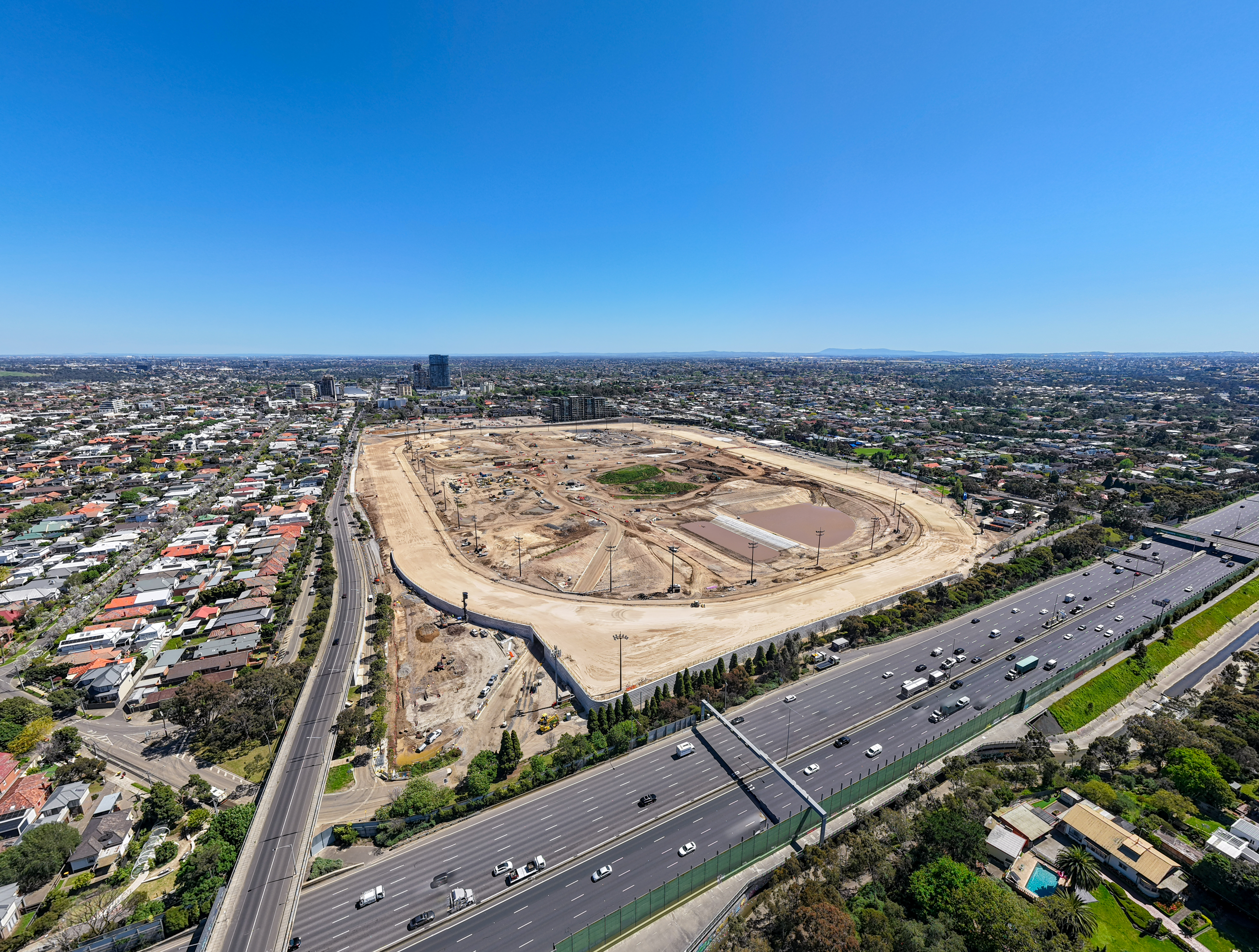

    Track handovers continue

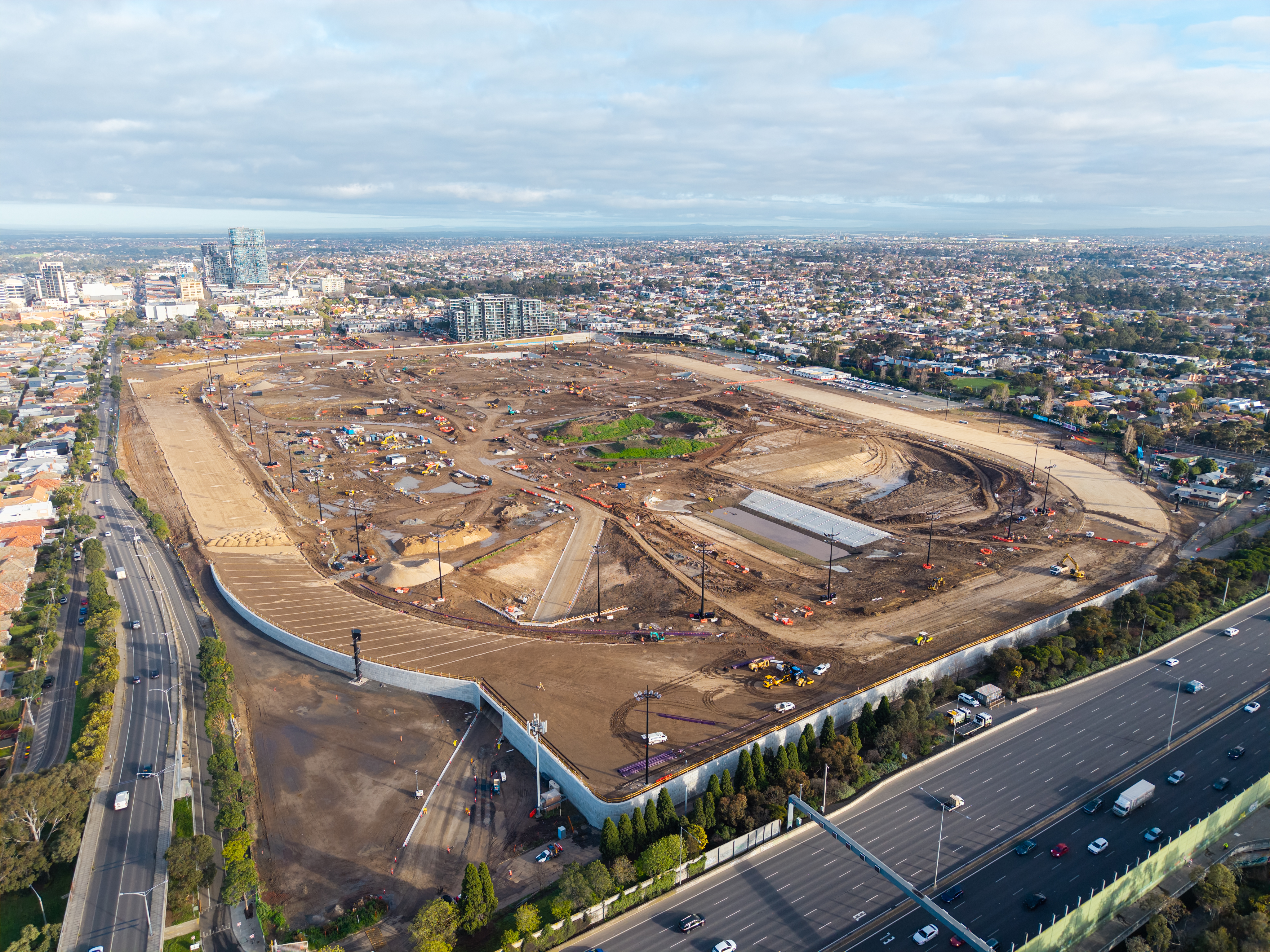

    Another section of the new racetrack was handed over to the turf specialist. Retaining wall works also progressed, with another major wall completed as construction continued across the wider precinct.
  • 2026 • September

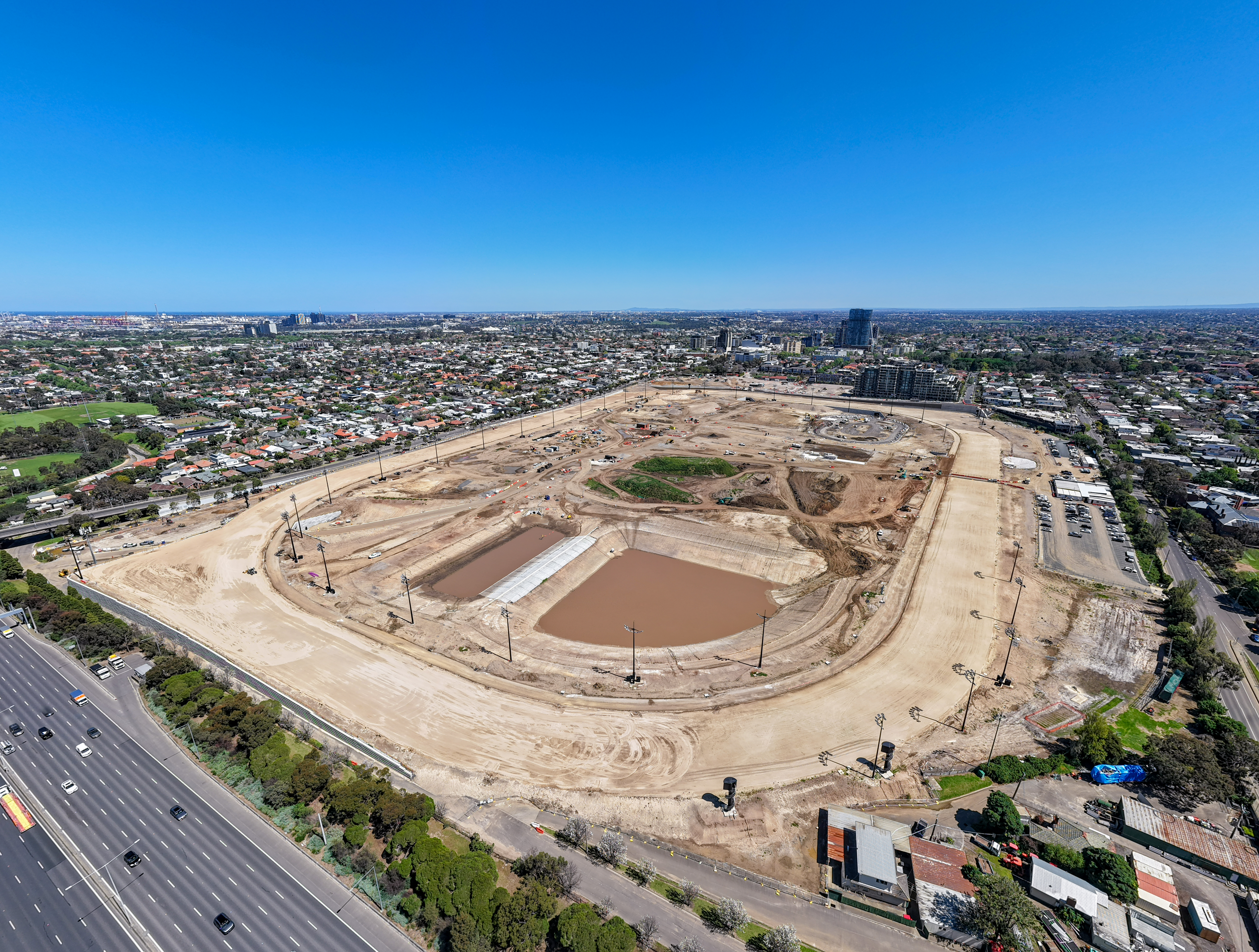

    Track handovers complete

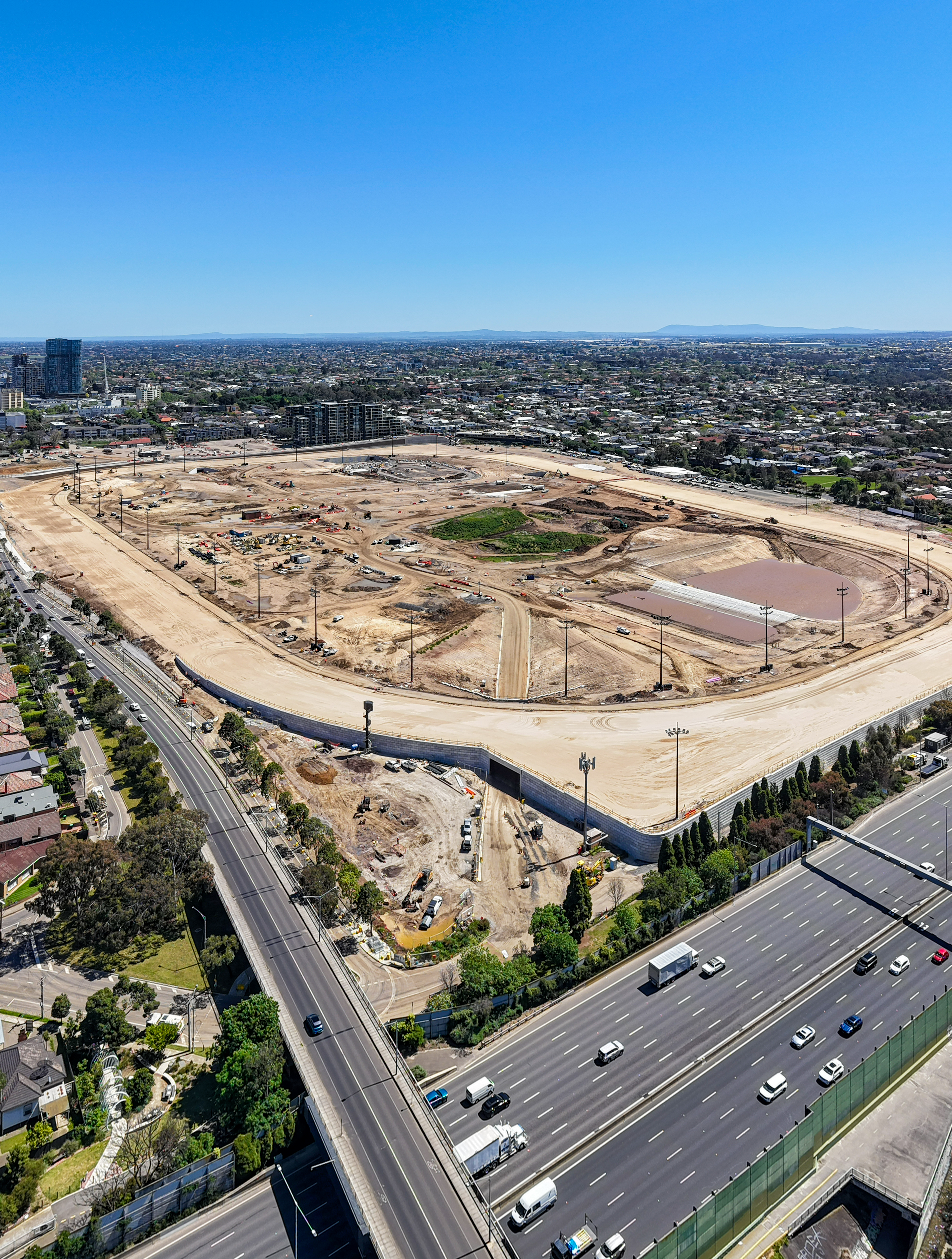

    The final separable portions of the new racetrack were handed over to the turf specialist, marking a major milestone towards the return of racing at Moonee Valley. The final track retaining wall was completed, alongside further progress on steward towers and track lighting infrastructure. Works also commenced on the Dean Street shared use path, while electrical and hydraulic works continued across the site, including track lighting switchboards, hydraulic connections and car park lighting infrastructure.
  • Symal Infrastructure
  • | Symal Contractors
  • | Contracting
  • | Sports and recreation
  • | Community infrastructure
